Setting Due Dates and Prioritizing Tasks in Atarim

Make deadlines visible and urgency obvious — so the next thing to work on is never a question.

Atarim team Updated 29 Jul 2026 · 8 min read

Managing Projects

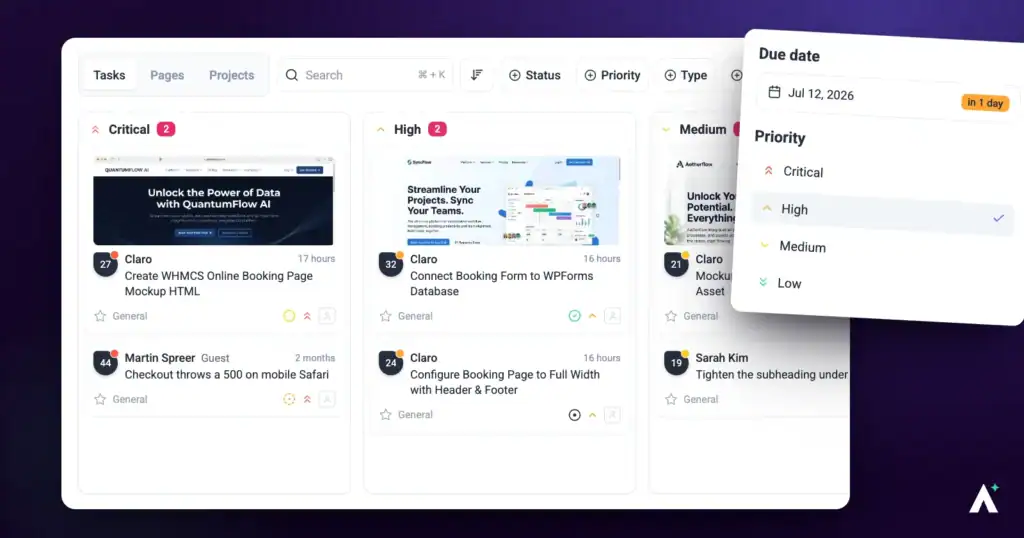

Atarim board grouped by task priority with due dates
Before you start

Relevant for

  • Project managers planning work
  • Anyone deciding what to do next from a long list

Required knowledge

  • Familiarity with opening a task in the Inbox, on Boards, or in Collaborate.

Tools & resources needed

  • A project with tasks in it.
  • A plan that includes task status and priority.

Priority and due dates answer different questions. Priority is how much something matters relative to everything else. A due date is when it has to be done. A task can be Critical with no deadline, or Low with a hard date next Tuesday.

Used together they mean nobody has to ask what to pick up next.

Status and priority are a paid feature
Gated as Task Status & Priority. On plans that do not include them the controls open an upgrade panel naming the plan required. Learn More About What A Task Holds

The Four Priority Levels

Four levels, deliberately few. The value is in everyone using them the same way, so it is worth agreeing what each one means for your team.

PrioritySuggested meaning
LowWorth doing, no deadline pressure. Picked up when there is room.
MediumNormal work in the queue. The default for most things.
HighNeeds attention this week.
CriticalBlocking something, or client-facing and broken.

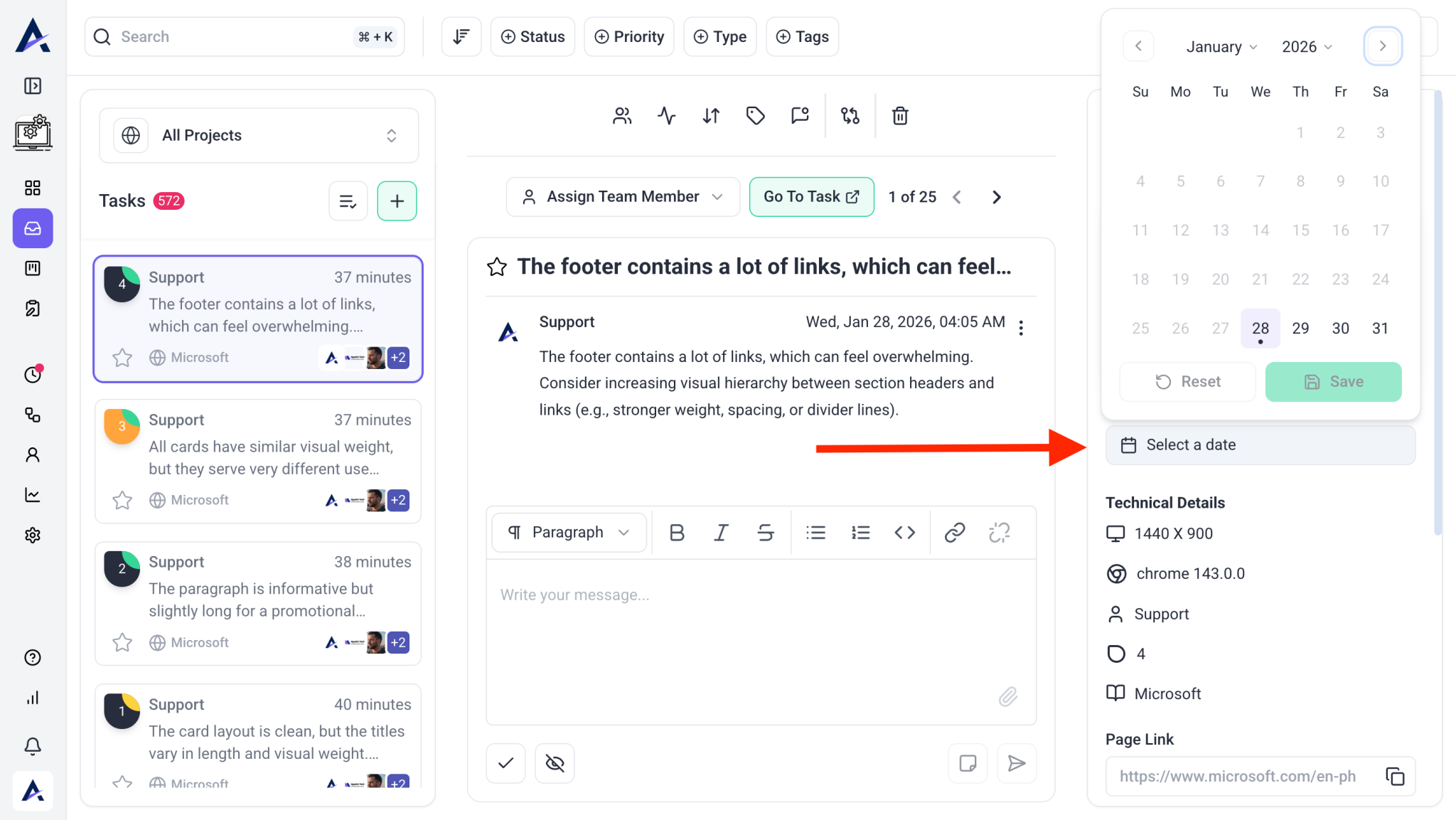

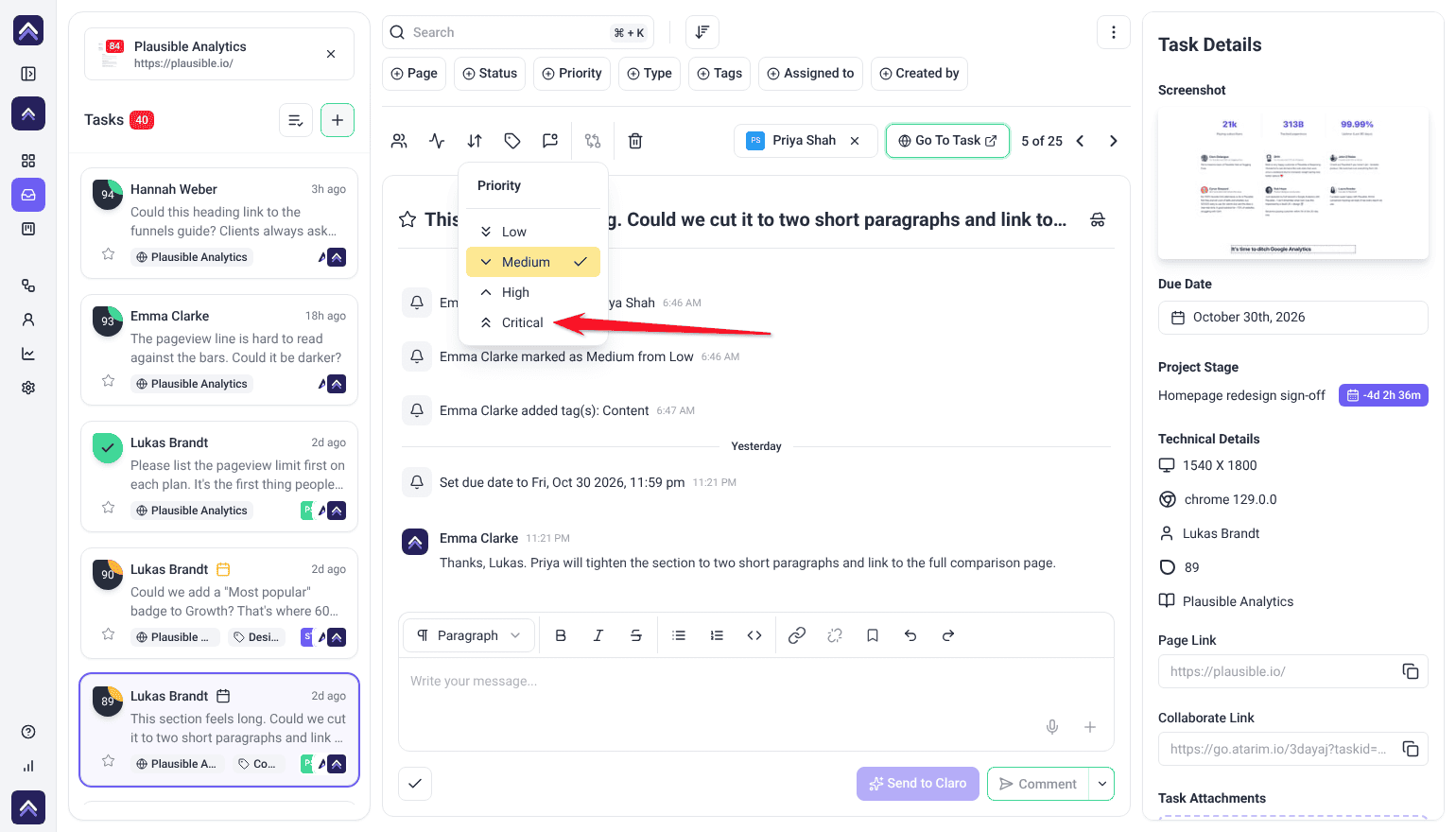

  1. Open the task in the Inbox, on Boards, or in Collaborate.

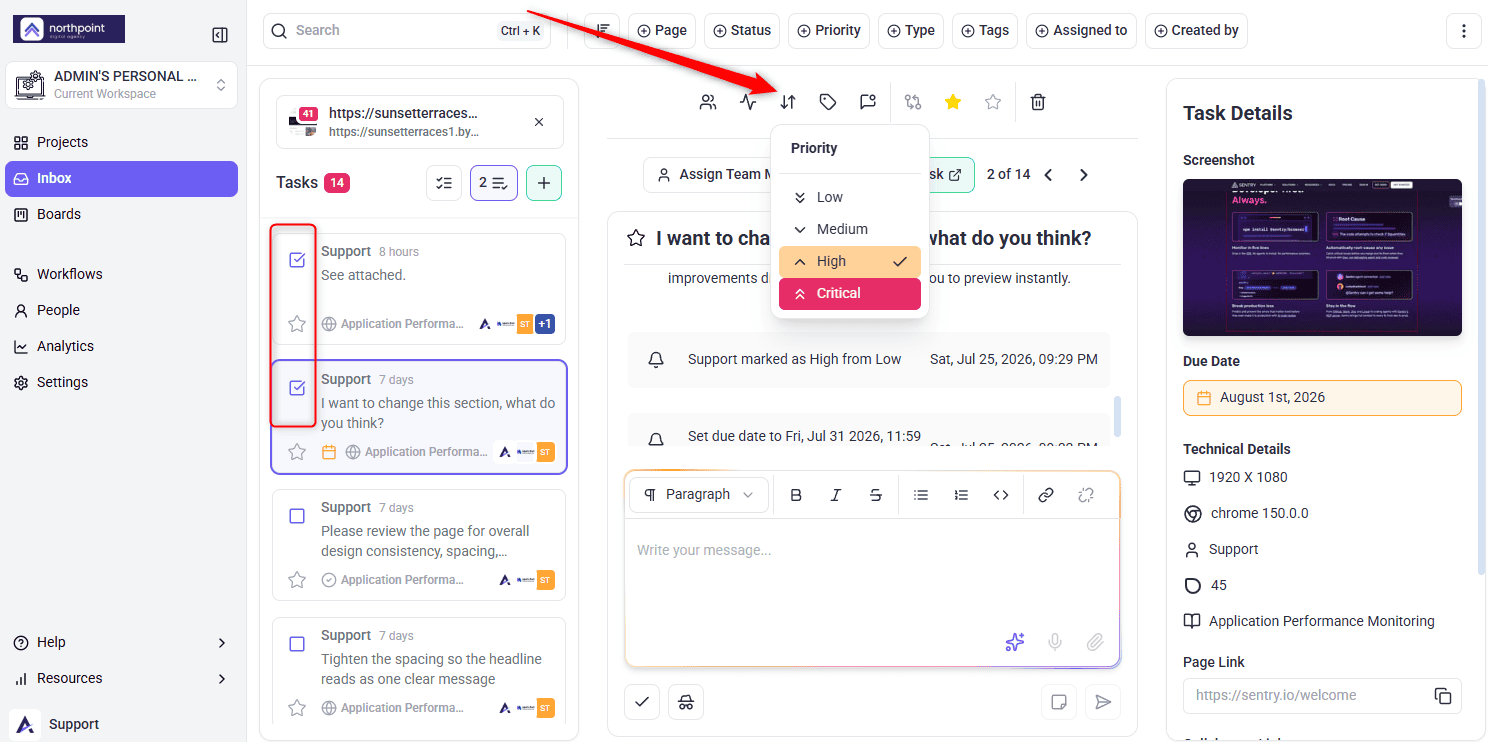

  2. Select the priority control and choose a level. The change saves immediately and everyone sees it.

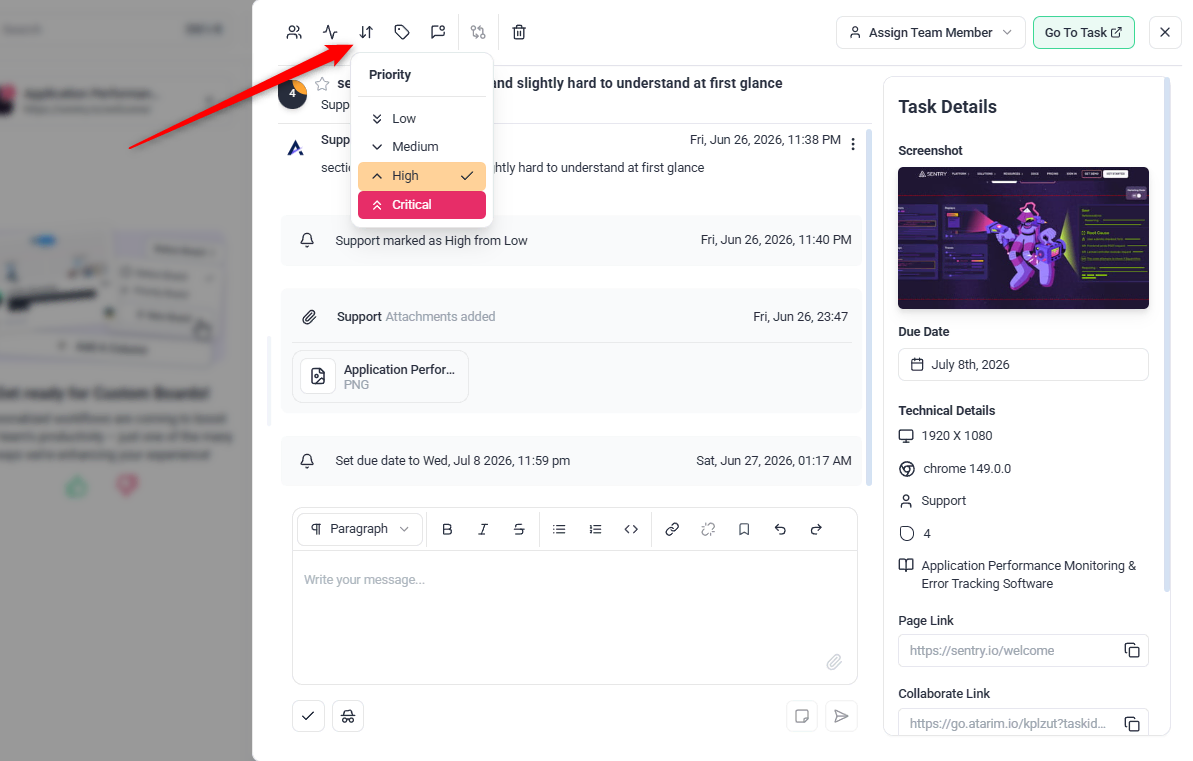

The priority control on a task — four levels, saved immediately
Agree what Critical means before you need it, and keep it rare
If a third of the board is Critical, the level has stopped carrying information — and the genuinely urgent work is hidden among things that merely feel urgent.
Priority is independent of status
Setting something Critical does not start it, and completing work does not clear its priority — they are answering different questions. Explore Tracking Task Progress and Completion.

Prioritising a Batch by Dragging

Setting priority one task at a time is fine for a few. After a client review drops forty, the board is the faster route — because it can group by priority instead of status.

  1. Open Boards and switch it to priority view. The columns become Low, Medium, High, and Critical.
  2. Drag each card into the column that matches its urgency. Dragging in this view sets the task’s priority, so triaging and setting are the same action.
  3. Switch back to status view to carry on working.

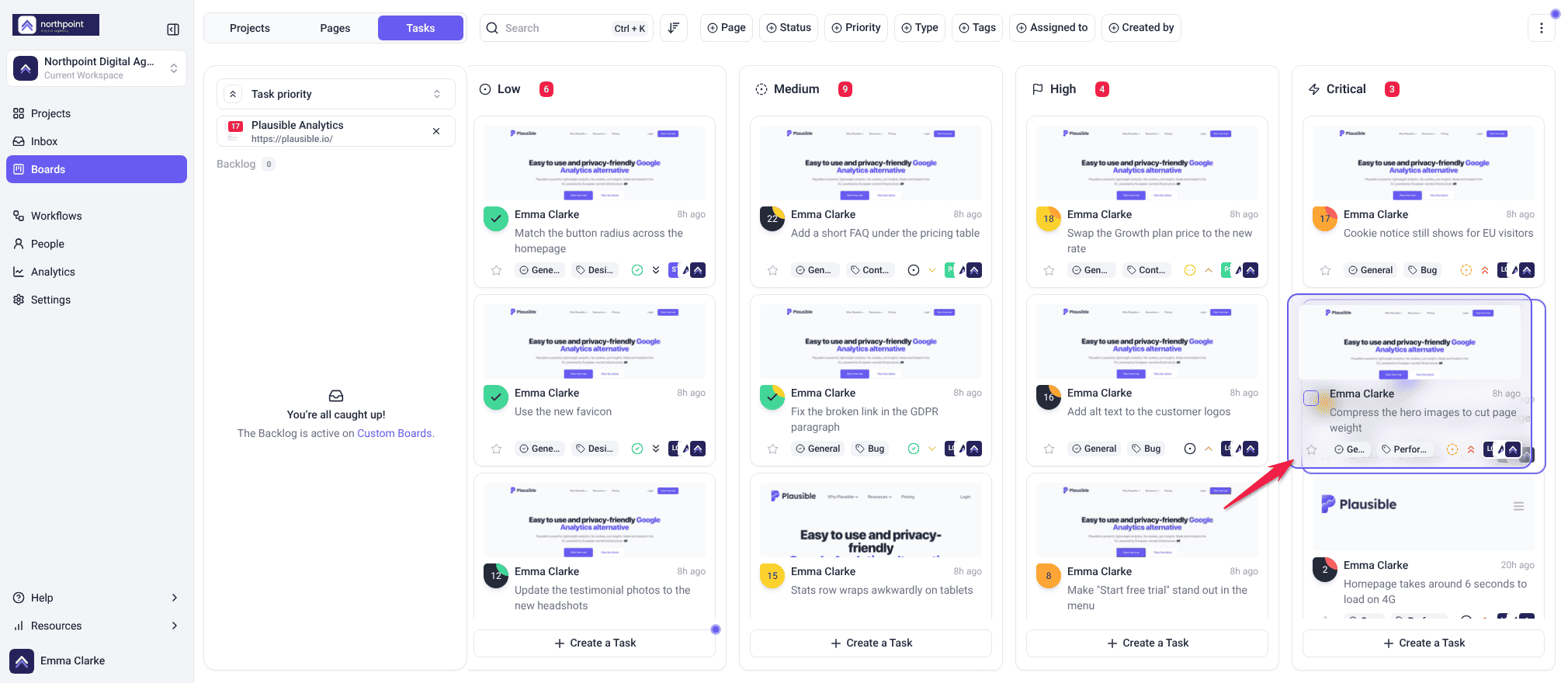

An Atarim board grouped by priority, with cards being dragged between Low, Medium, High, and Critical columns
In priority view, dragging a card sets its priority
This is the fastest triage in Atarim
Forty untriaged tasks become a sorted board in a couple of minutes, and the priorities are set as a side effect rather than a second pass. Discover Kanban Boards

Setting Priority in Bulk

Where a whole batch shares the same urgency, select them and set it once.

  1. Filter to the tasks you mean — one client, one tag, one status.
  2. Hover a card to reveal its checkbox and select the tasks, or use Select all visible tasks.
  3. Use the priority control on the bulk toolbar. Every selected task is set to that level at once.

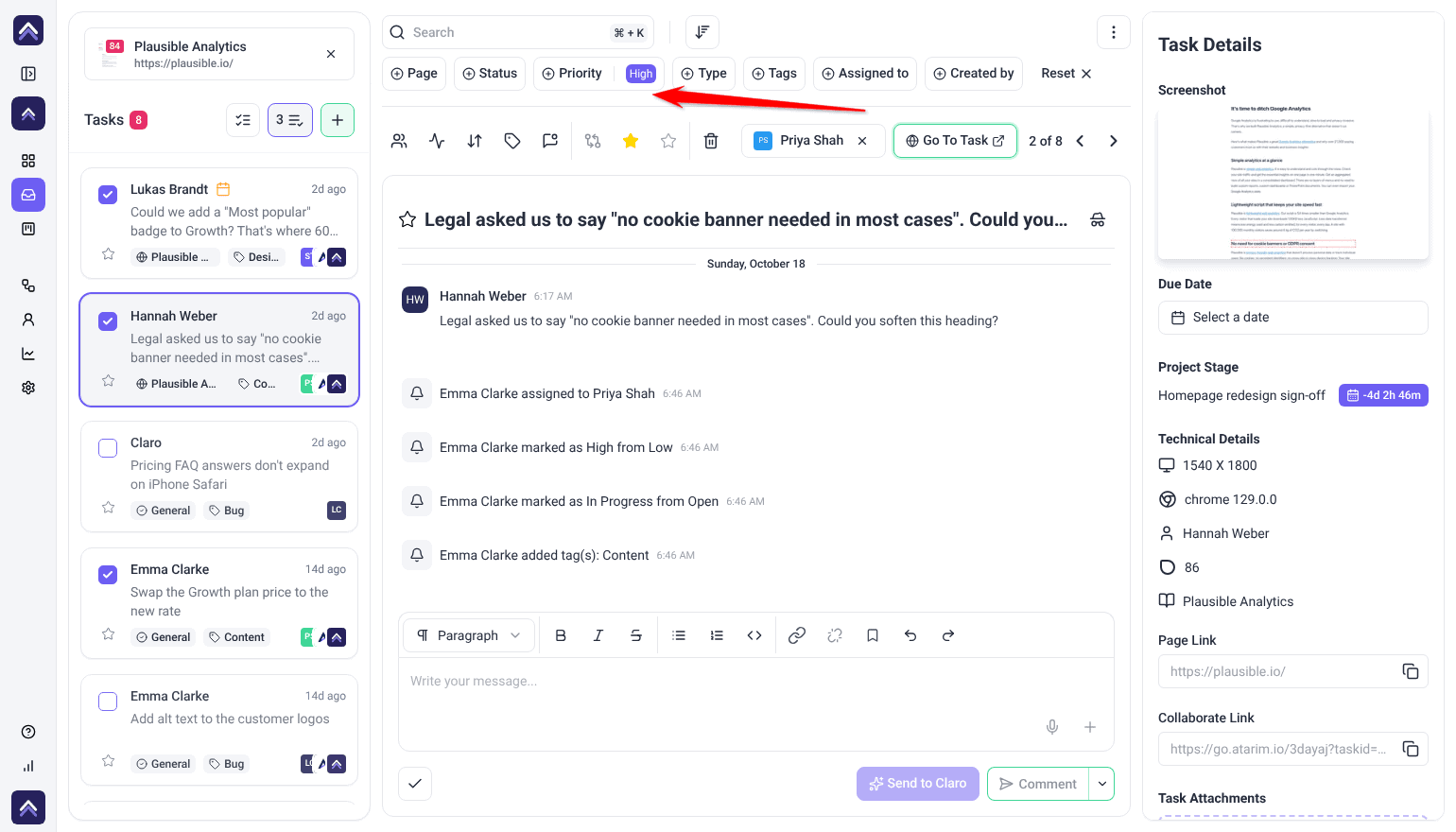

Filtering by priority narrows the list before a bulk change
Filter before selecting all
Select all visible tasks takes everything on screen after filters, so narrowing first is what keeps a bulk change from reaching further than you intended.

Setting a Due Date

A due date can be set from any view, and it saves as soon as you choose it.

  1. Open the task from the Inbox, Boards, or Collaborate.

  2. Select the Due Date field to open the date picker.

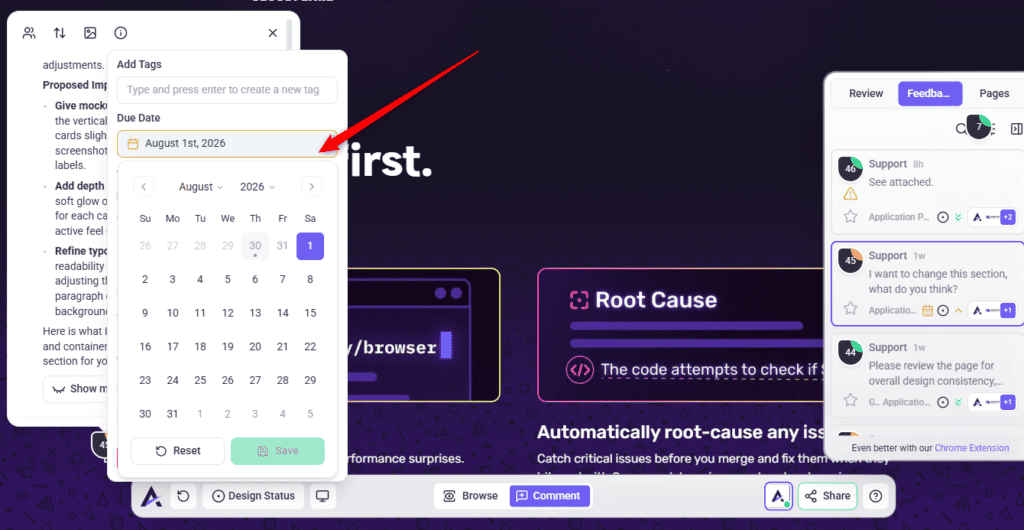

  3. Choose the date. It saves automatically and is visible to everyone on the project.

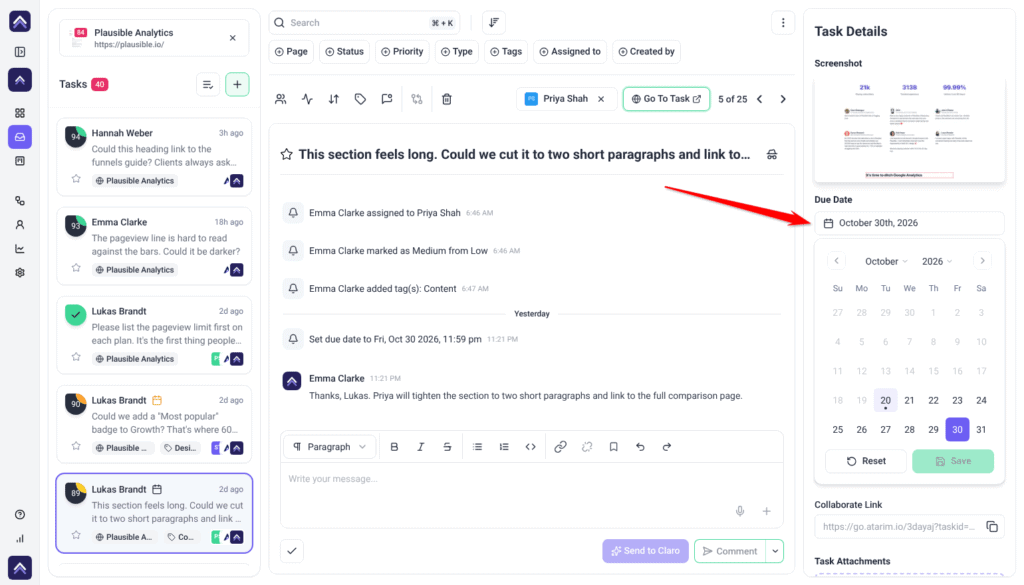

Setting a due date from the Inbox

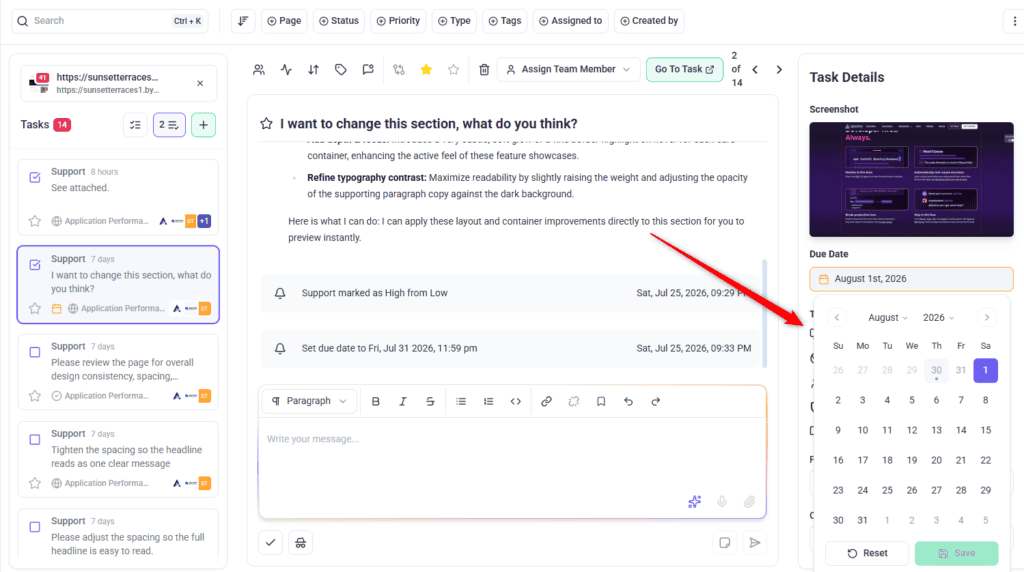

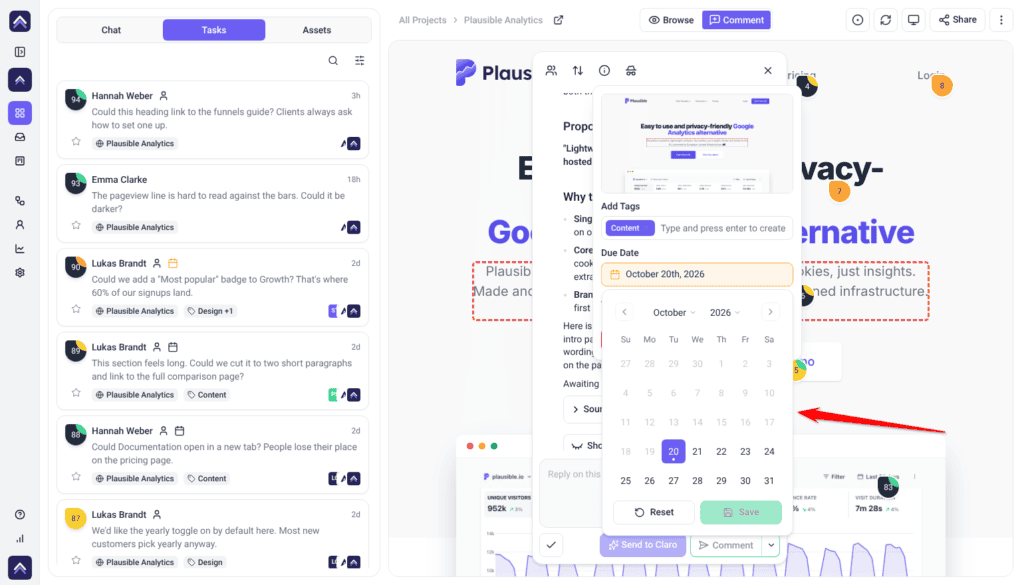

The same field in Collaborate
Date the things that genuinely have dates
A board where every task has a date tells you nothing; a board where eight do tells you exactly where the week’s pressure is. Discover How To Manage Tasks

What the Due Date Colours Mean

This is the part that makes due dates useful rather than decorative. The date indicator changes colour as the deadline approaches, so an overdue task is visible without opening anything.

ColourMeansThe tooltip shows
No colourMore than 72 hours away, or no due date set.
OrangeDue within 72 hours.How long is left.
RedOverdue.Exactly how late — Overdue by 3 days 4h, or Overdue by 6 hours for anything under a day.
Treat orange as your cue to act, not red
Seventy-two hours is enough warning to move a date honestly or push the work through. By the time something is red, whoever was waiting has already been let down. The tooltip gives the exact overage rather than just “overdue”, which matters when you need to know whether something slipped by an hour or a fortnight.

The same colours appear wherever task cards do, so a board and the Inbox both surface an approaching deadline at a glance. Learn More About Reading Task Cards On Boards

Sorting by Priority

Once priorities are set, sorting turns them into a working order.

Sort optionUse it to
Priority: High To LowStart the day with the most urgent work at the top.
Priority: Low To HighClear quick, low-stakes items when you have a short window.
Newest Task FirstSee what has just come in.
Oldest Task FirstFind what has been waiting longest.
  1. Open the Inbox and find Sort Tasks.
  2. Choose an order. The list reorders immediately.
There is no sort by due date
The Inbox sorts by date created and by priority, not by deadline. To work by deadline, filter to what is relevant and read the colours — orange and red are what surface an approaching date.
Tip
Priority: High To Low plus Assigned To Me is the closest thing Atarim has to a personal to-do list. Learn More About Assigning Work

Automating Priority and Chasing Deadlines

Priority is the one field workflows handle well, because urgency often follows a rule. And since Atarim does not send deadline reminders by itself, a workflow is how you get one.

What you wantHow to build it
Alert the team when something becomes CriticalTask priority changes trigger, a Task priority is set to condition for Critical, then a notification.
Set priority automatically on arrivalTask added trigger with a Change task priority step.
Chase work that has gone quietA status change, a Delay of a few days, then a comment or notification.
Escalate ageing workA Delay followed by Change task priority to raise it.
Recommendation
A workflow that notifies your team the moment anything is set to Critical is worth building early. It turns the level from a label into an actual alert, and none of those steps cost credits. Discover Workflow Automation

Project Deadlines Are Different

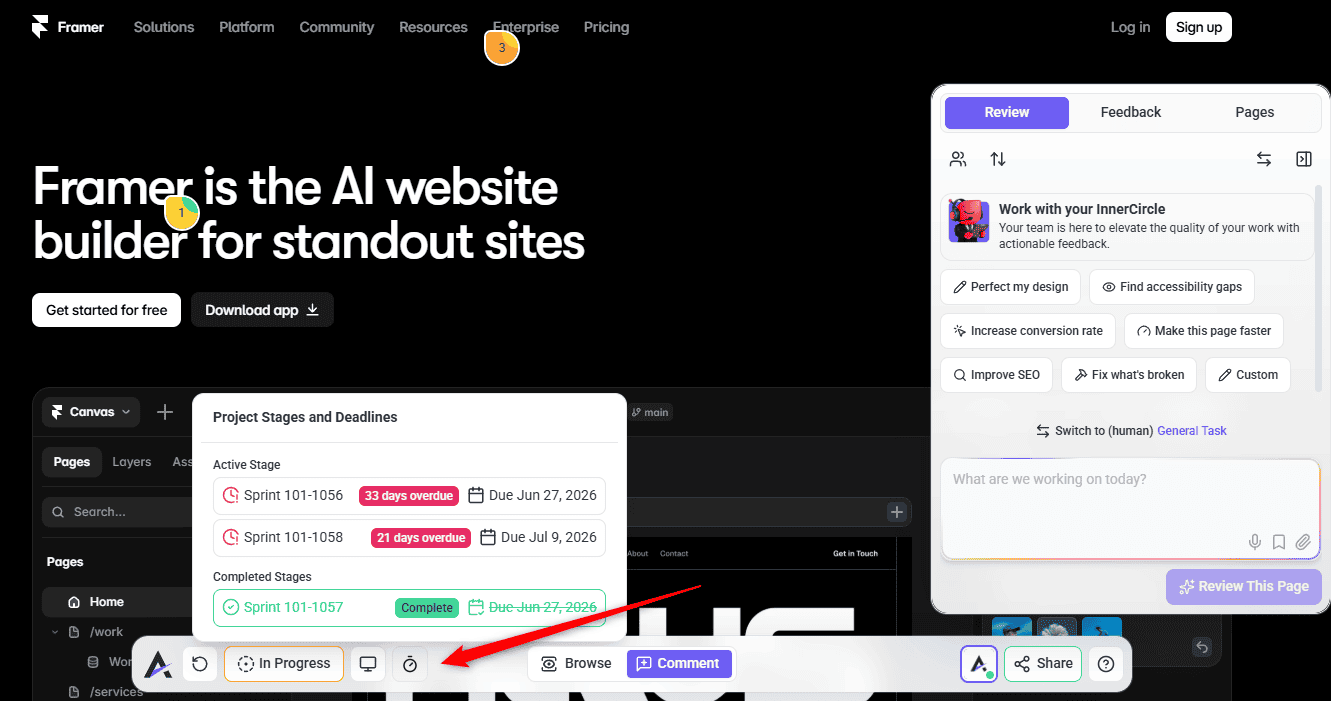

Task due dates are for individual pieces of work. Deadlines for a whole project are handled by project stages instead, which show clients where a project has reached. Explore Project Stages

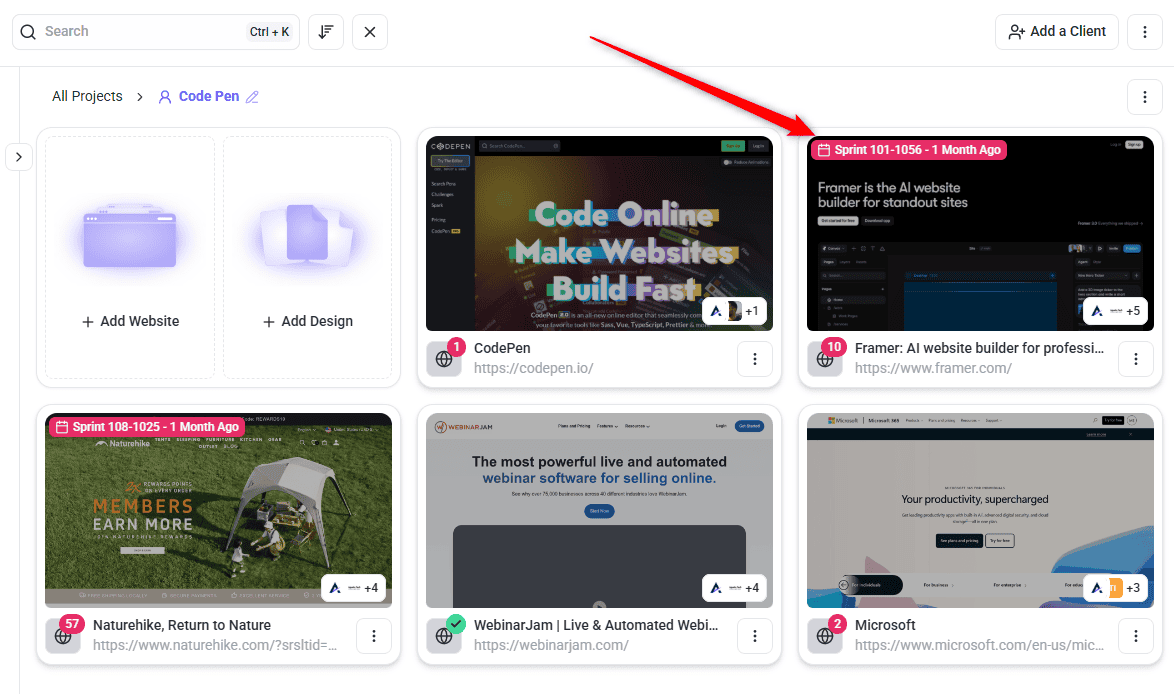

Stage deadlines belong to the project, not to a task

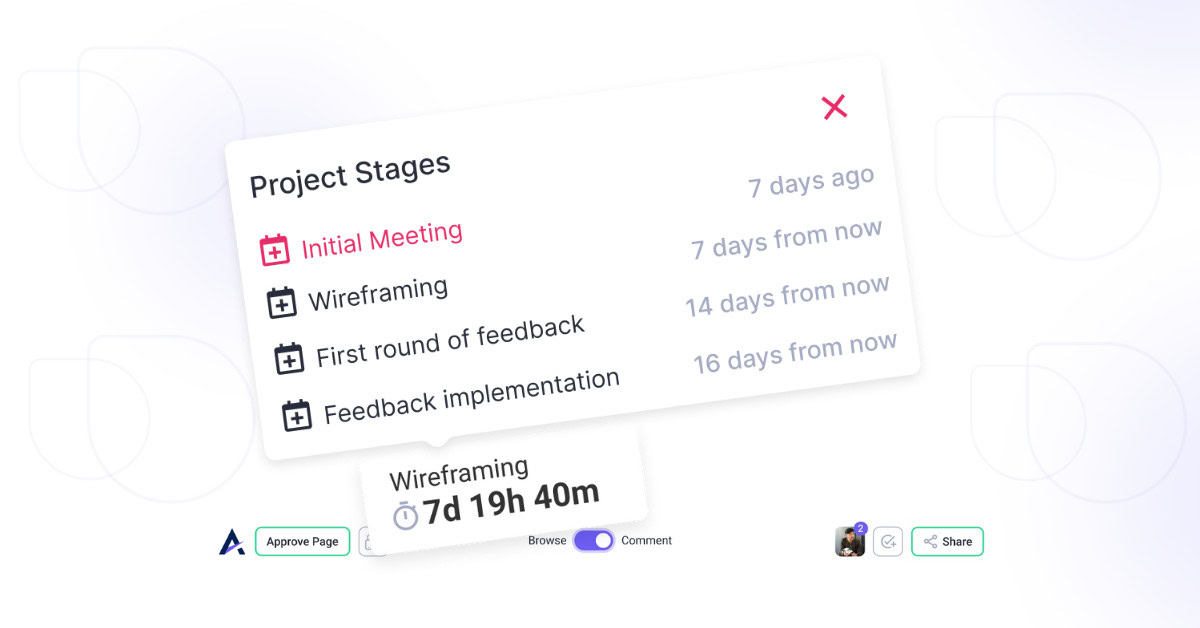

Each stage carries its own due date

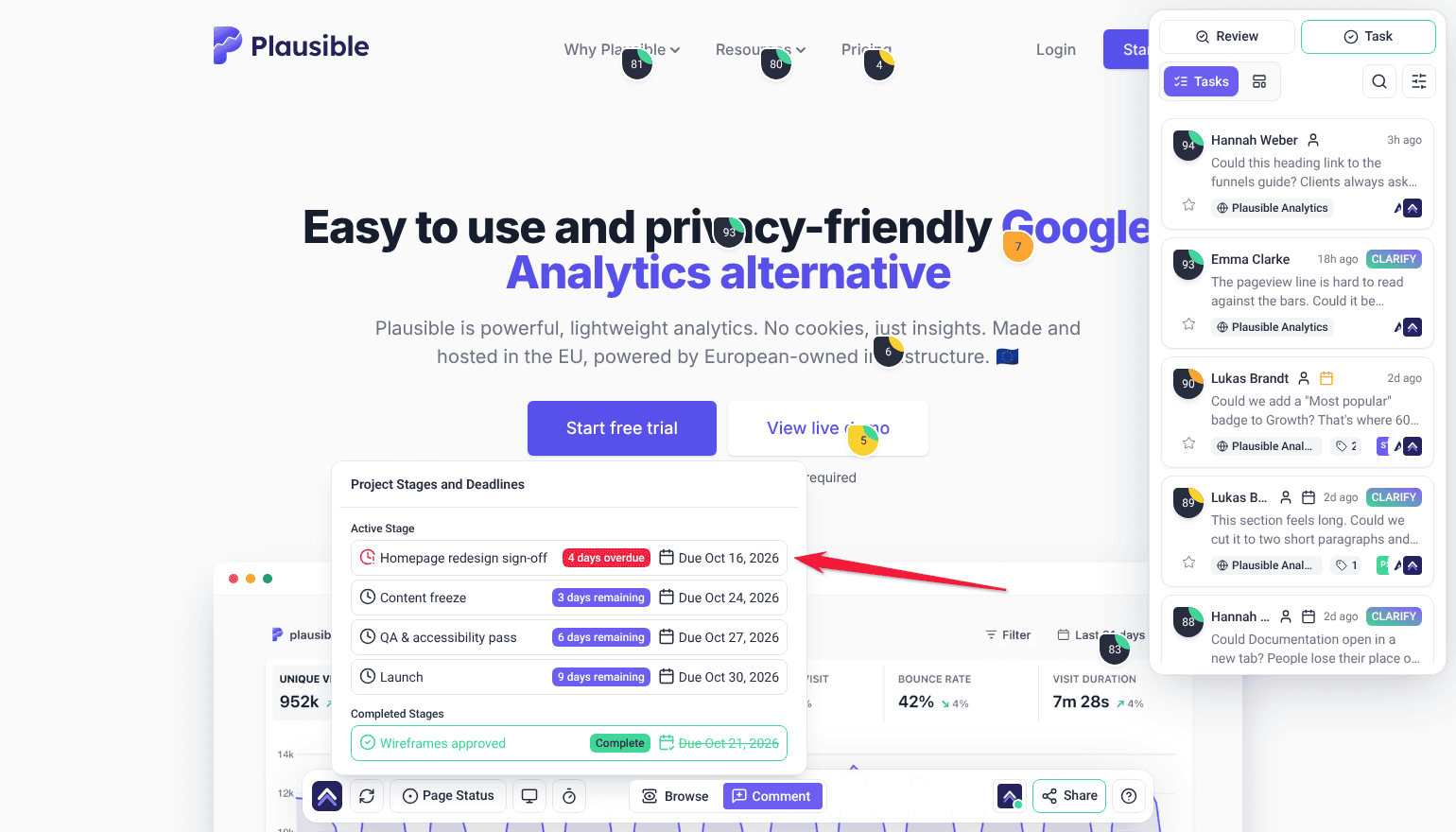

How stage deadlines appear to the team and the client

Seeing Whether It Is Working

Priorities and dates are only useful if the pattern they create is a healthy one, and reporting is where that shows.

  1. Open Analytics and look at the Overview tiles. The high priority percentage tells you whether Critical is being used sparingly or as a default.
  2. Check turnaround and completed-on-time figures. If dates are consistently missed, they are being set optimistically rather than realistically.
Tip
A high proportion of urgent tasks is usually a triage problem rather than a busy period. If most things are High or Critical, the levels have stopped meaning anything. Explore Analytics & Metrics

Benefits of Using Both Properly

BenefitIn practice
The next task is obviousSorting by priority answers “what now” without a conversation.
Slipping work announces itselfOrange at 72 hours means you find out before the client does.
Triage takes minutesPriority view turns a review round into a sorted board by dragging.
Urgency can trigger actionA workflow on priority change turns Critical into a notification.
Overcommitment becomes visibleReporting shows whether dates are being met or quietly missed.

Example Use Cases

SituationWhat to do
Forty tasks after a client reviewSwitch to priority view and drag them into columns. Triage and priority in one pass.
A launch next FridayPut the date on the handful of tasks that must land, and leave the rest undated so the pressure is visible.
A whole client batch is urgentFilter to their tag, select all visible, and set the priority in bulk.
Starting your own dayAssigned To Me with Priority: High To Low.
A short window between meetingsSort Priority: Low To High and clear a few quick items.
Nobody notices when something turns CriticalBuild a workflow on the priority change trigger to notify the team.

Known Limitations

  • Status and priority are a paid feature.
  • There is no sort by due date — only by date created and by priority.
  • Due dates cannot be set in bulk. Priority can; dates are one at a time.
  • Four priority levels, fixed. They cannot be renamed or added to.

FAQs

What is the difference between priority and status?

Priority is how much something matters; status is how far along it is. They are independent, so a task can be Open and Critical.

Why has a task’s date turned orange?

It is due within 72 hours. Red means the date has passed.

Can I set due dates for several tasks at once?

No. Priority can be set in bulk, but dates are one task at a time.

Does Atarim remind me when a task is due?

Not on its own. Build a workflow with a Delay and a notification if you want reminders.

Can I sort my tasks by deadline?

No. The Inbox sorts by date created and by priority. Use the date colours to spot what is close.

What is the fastest way to prioritise a lot of tasks?

Switch Boards to priority view and drag the cards into columns — that sets the priority as you sort.

Can I add my own priority levels?

No. The four levels are fixed. Use tags for any further categorisation you need.

Common issues

  • The priority control shows a lock — status and priority are not on your plan. The panel names the minimum plan required.
  • A task’s date is orange or red — orange is due within 72 hours, red is overdue. Hover for the exact figure.
  • You cannot sort by due date — not available. Sort by priority and use the colours to spot approaching deadlines.
  • You cannot set dates in bulk — only priority can be set in bulk. Dates are per task.
  • Dragging changed priority instead of status — the board is in priority view. Switch back to status view.
  • Everything on the board is Critical — a triage habit rather than a real emergency. Agree what Critical means and re-triage in priority view.
  • Nobody is told when a deadline nears — there are no built-in reminders. Build a workflow with a Delay and a notification.

Conclusion

Keep priority meaningful by keeping Critical rare, and keep due dates meaningful by putting them only on work that genuinely has one. Then priority view handles triage, the colours handle warning you, and a workflow handles telling everyone — which leaves the actual judgement as the only part you have to do yourself.
